Whole Main-Floor Renovation in Hagersville: 1,325 sq ft Rebuilt — completed by HMH Construction

Project story · Hagersville

Whole Main-Floor Renovation in Hagersville: 1,325 sq ft Rebuilt

New island kitchen, two bathrooms, 650 sq ft of hardwood and 900 sq ft of popcorn ceiling gone — three weeks, one continuous run.

Location
Hagersville
Completed
2023
Duration
About 3 weeks — February 6 to February 24, 2023
Project value
About $34,000 + HST — signed contract, January 2023

Nothing in this house was broken. It was just original: cream raised-panel kitchen cabinets, a laminate top with a drop-in double sink, a mirrored backsplash, beige ceramic tile in the kitchen and entry, carpet in the bedrooms, and popcorn on 900 square feet of ceiling. Rather than pick a room and start there, the whole main floor was written into one contract and one three-week run.

What the project had to achieve

Read from the scope of work: Every line in the contract is a dated finish rather than a failure — cabinets, counters, flooring, baseboards, two vanities, popcorn ceiling — so this reads as a pre-occupancy reset, not a repair. The schedule supports that: two to three continuous weeks with demolition, ceilings, flooring, the kitchen and both bathrooms overlapping only works in an empty house. The kitchen carried most of the budget, and the shape of that spend tells you what the renovation was for: 25 linear feet of cabinets plus a 72-inch island with finished panels turns a closed perimeter galley into a kitchen you can work at from both sides. The rest of the scope exists to keep that from looking like one updated room in an old house — one hardwood floor running unbroken through kitchen, dining and living, smooth ceilings overhead, new baseboard against all of it.

Project goals here are read from the signed scope of work. We don't publish our clients' names, addresses, or anything they told us in confidence.

Scope of work

How it was built

  1. January 2023

    Before — original finishes, top to bottom

    A 1,325 sq ft detached bungalow with the finishes it was built with. Cream raised-panel uppers and lowers, laminate counter, drop-in double-bowl sink, mirrored backsplash, and no island — just a perimeter run with a walk-through to the deck door. Ceramic tile in the kitchen and entry, carpet in the bedrooms, popcorn ceiling overhead. Two bathrooms, one with a pedestal sink and one with a builder oak vanity.

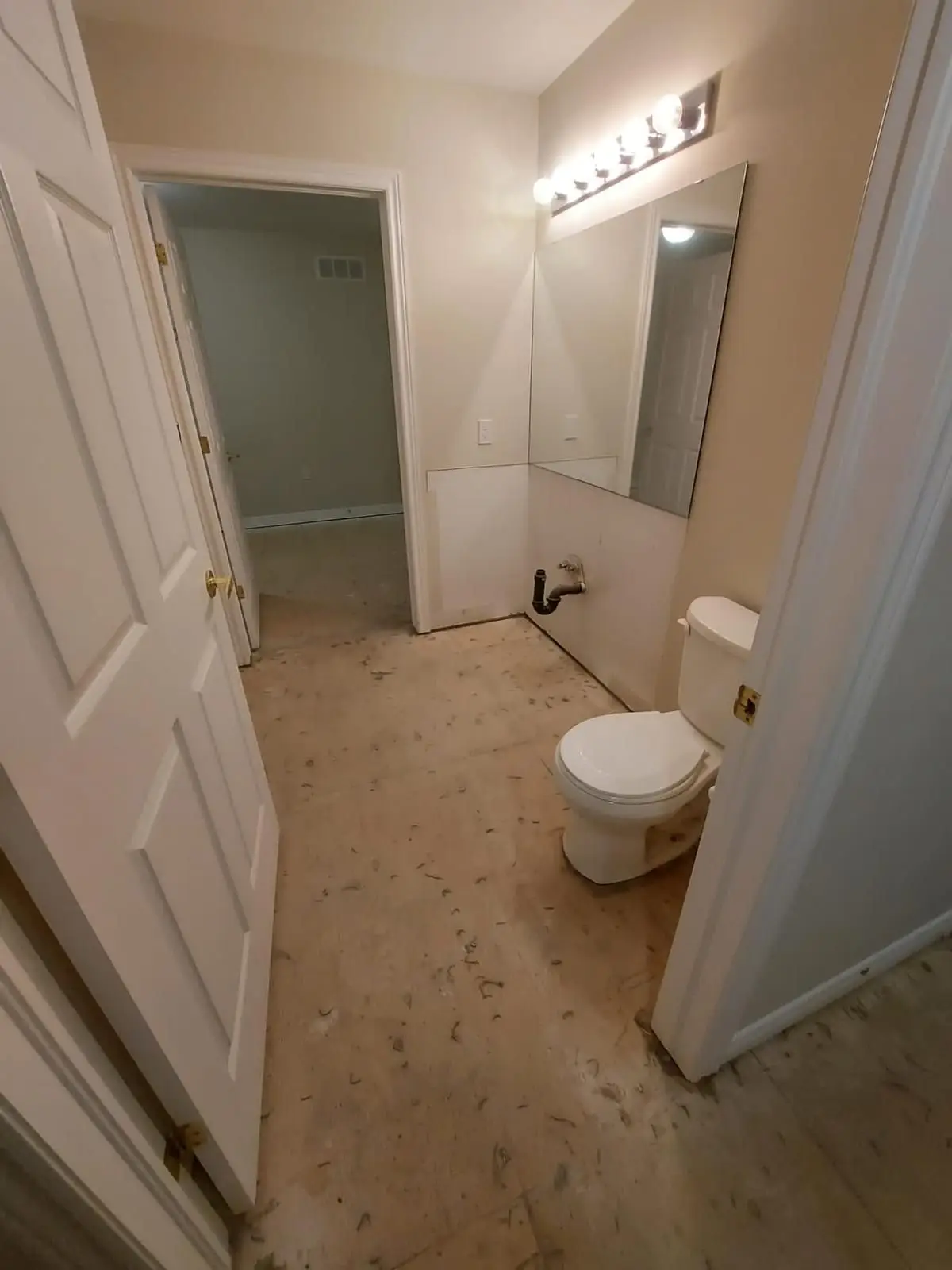

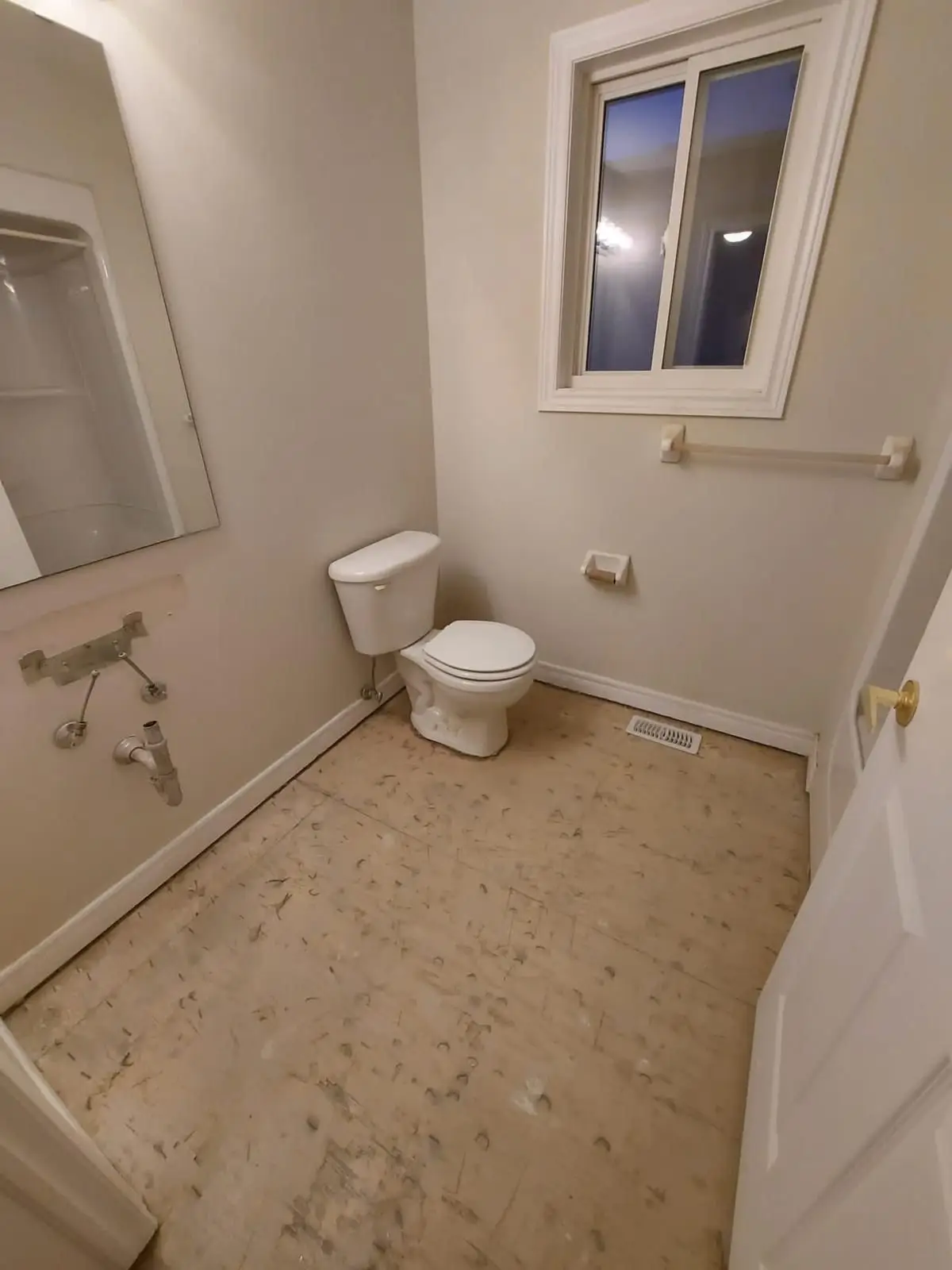

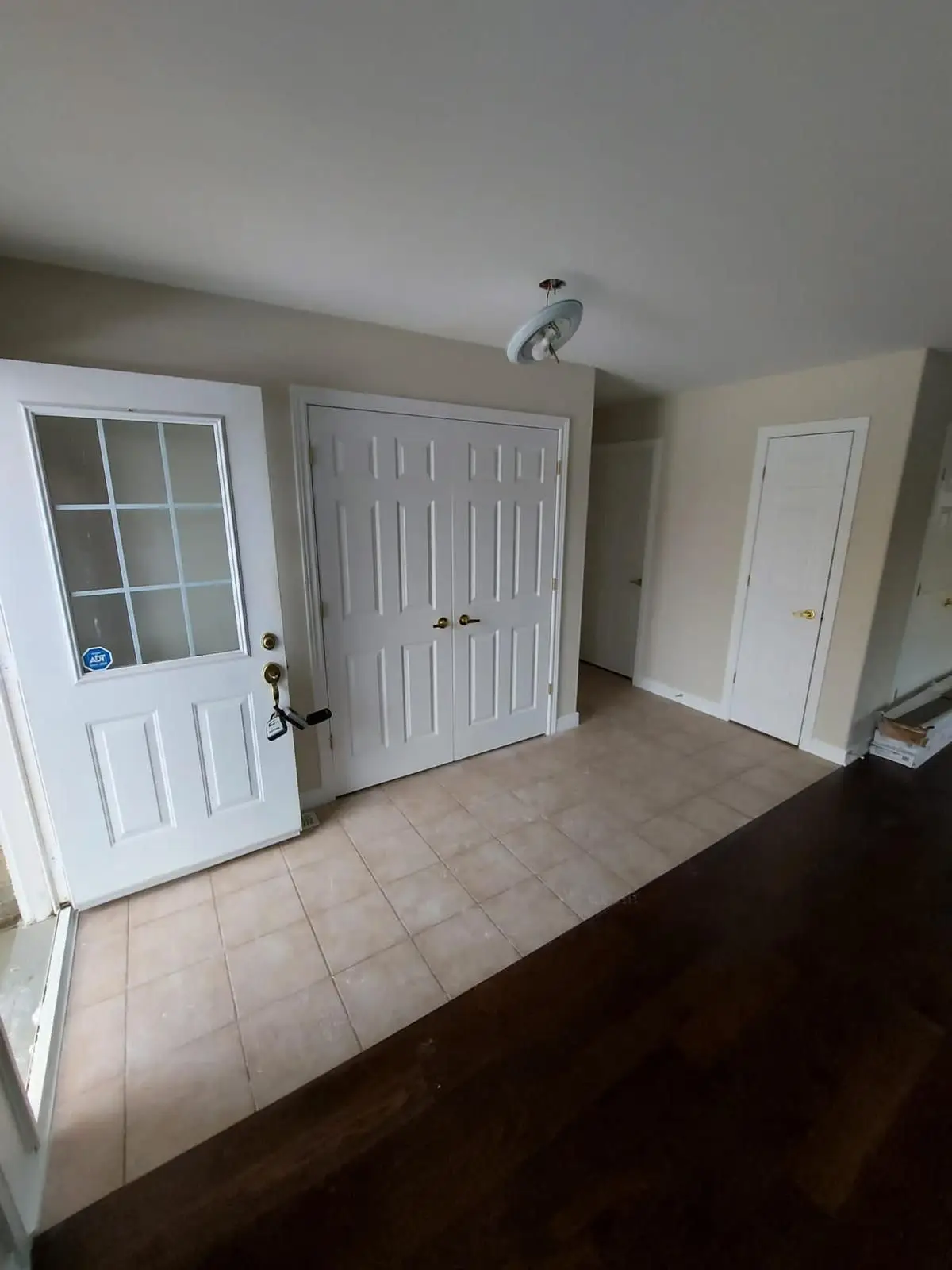

    Before — Wide shot of an entryway with tiled floor, front door, closet doors, and transition to hardwood flooring.Demolition — Bathroom during demolition with missing vanity, exposed subfloor, and toilet still installed.Demolition — Bathroom undergoing demolition with subfloor exposed and vanity removed, showing toilet and mirror.
  2. January 2023

    Design, then a fixed scope and a start date

    The kitchen was drawn in 3D before a single cabinet was ordered — 25 linear feet of boxes, the 72-inch island, quartz counters with a full quartz backsplash, the pantry wall beside the fridge, and where the range and dishwasher land. The two images below are those design renderings, not photographs. Contract signed January 27, 2023 at $34,481 + HST, start date February 6, duration understood as two to three weeks. Electrical and plumbing were quoted separately by the licensed subtrades and approved before the crew showed up, so nothing on site waited on a price.

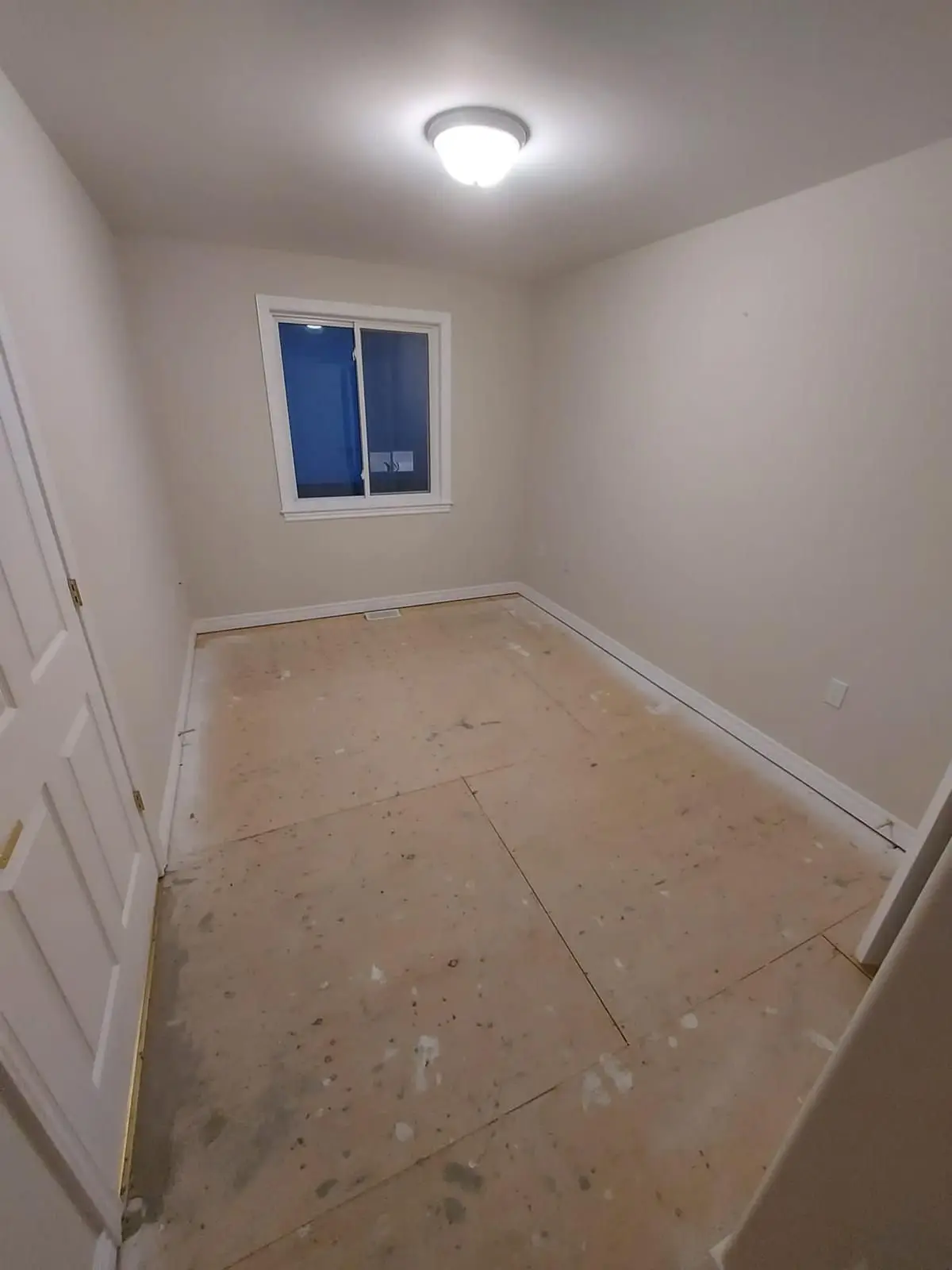

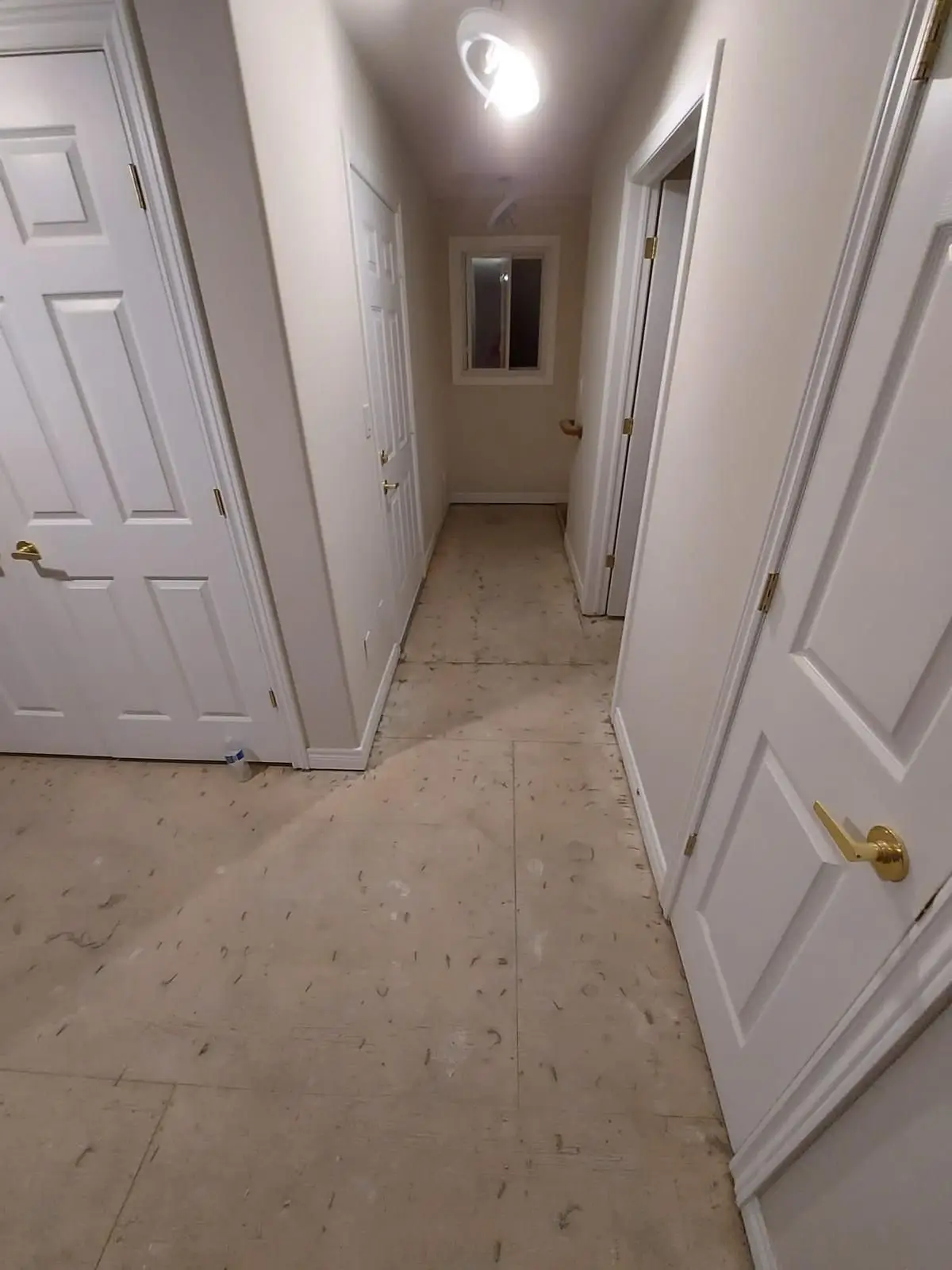

    Insulation & drywall — Empty room with painted walls, trim, and subfloor awaiting flooring installation.Insulation & drywall — Long narrow hallway view showing subfloor and multiple white paneled doors during interior renovation.
  3. Early February 2023

    Demolition and rough-in

    The main floor came apart in one pass. Kitchen cabinets and both vanities out, tile and carpet lifted down to the plywood subfloor, baseboards off, 900 sq ft of popcorn ceiling scraped and re-plastered. Kitchen supply and drain were left stubbed at the wall for the new sink run, drywall was patched everywhere the old uppers and backsplash came off, and the pot light holes were cut while the ceiling was still open work. The dishwasher was wrapped and parked in the corner for reinstall.

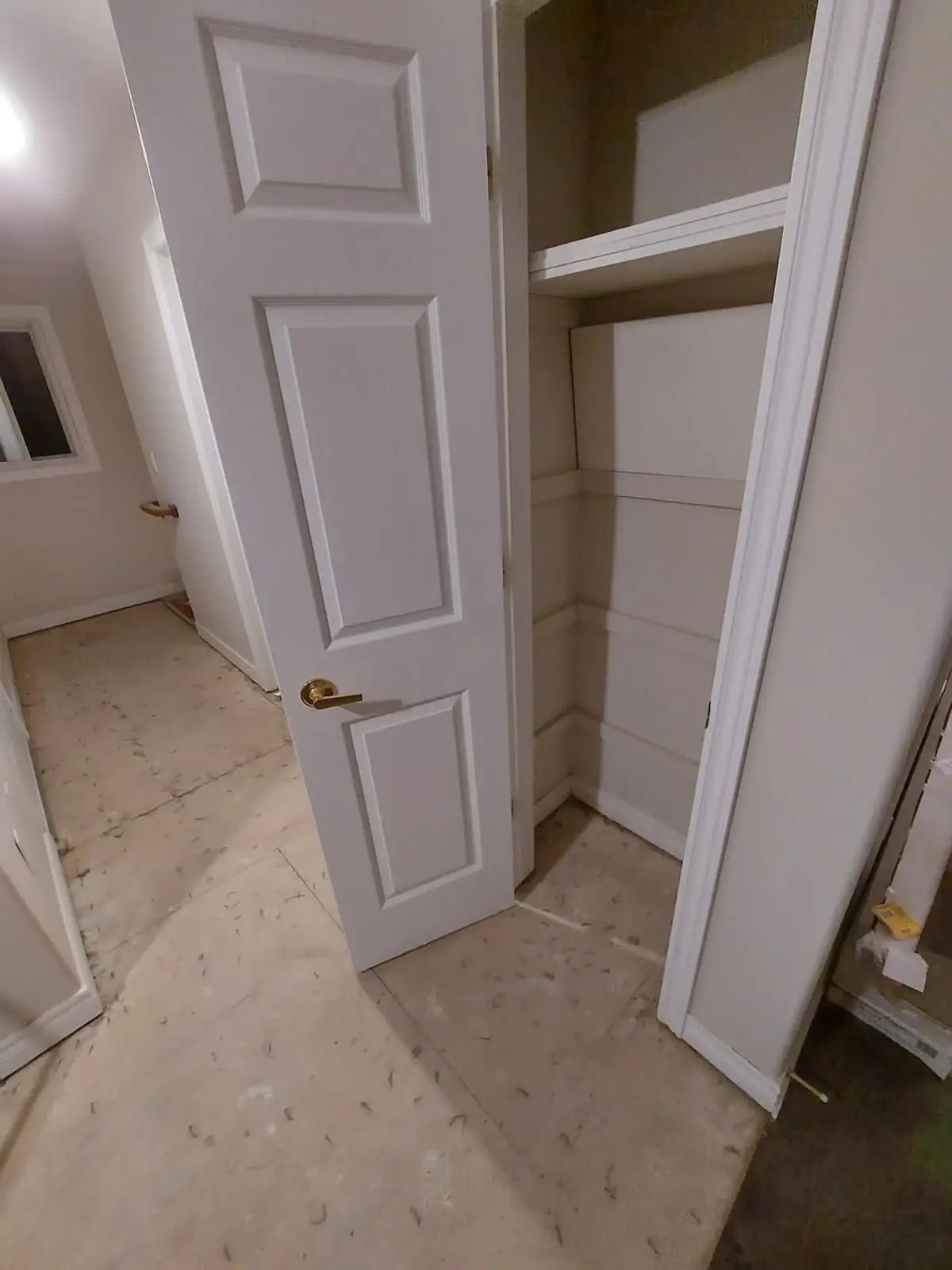

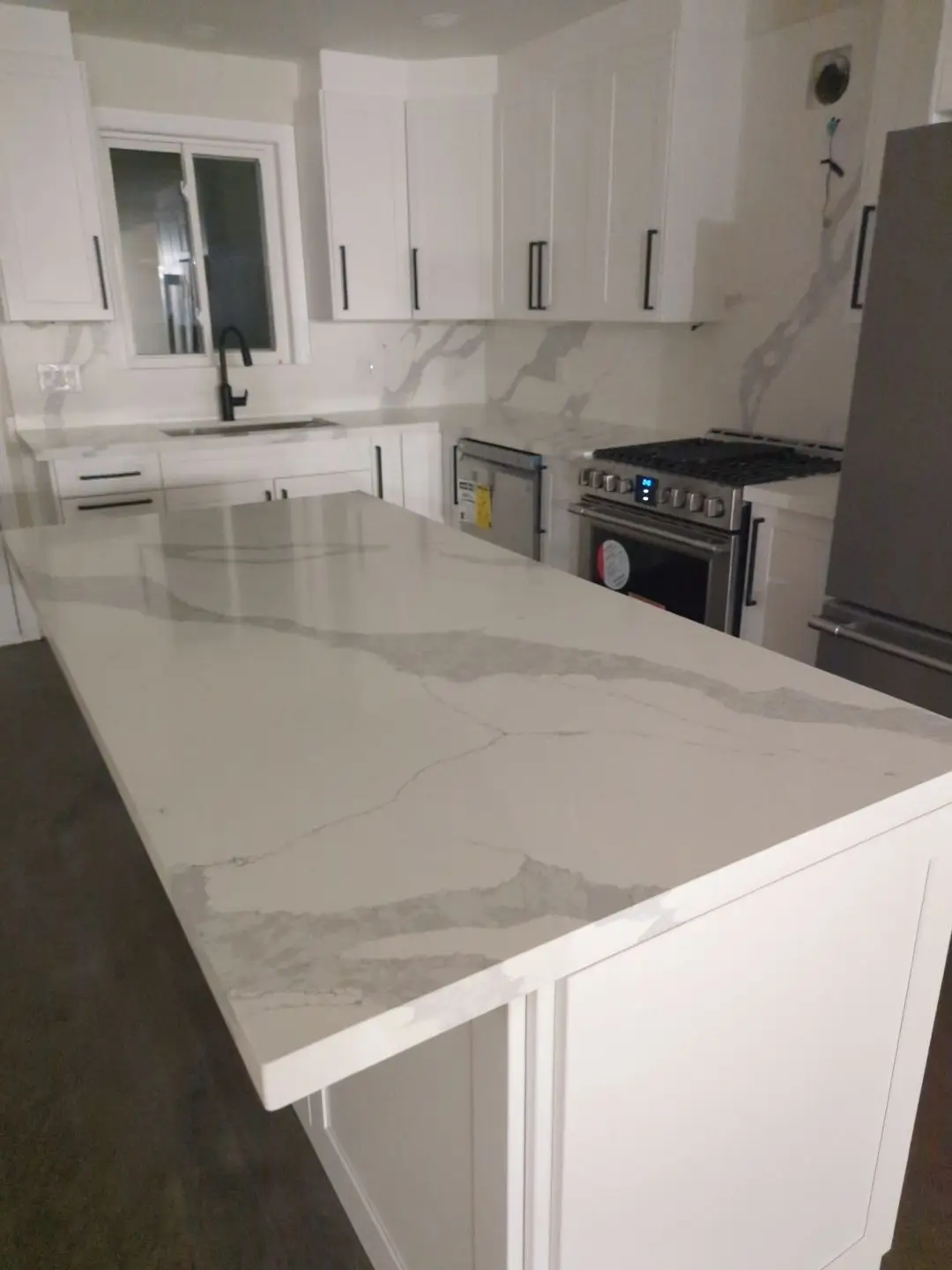

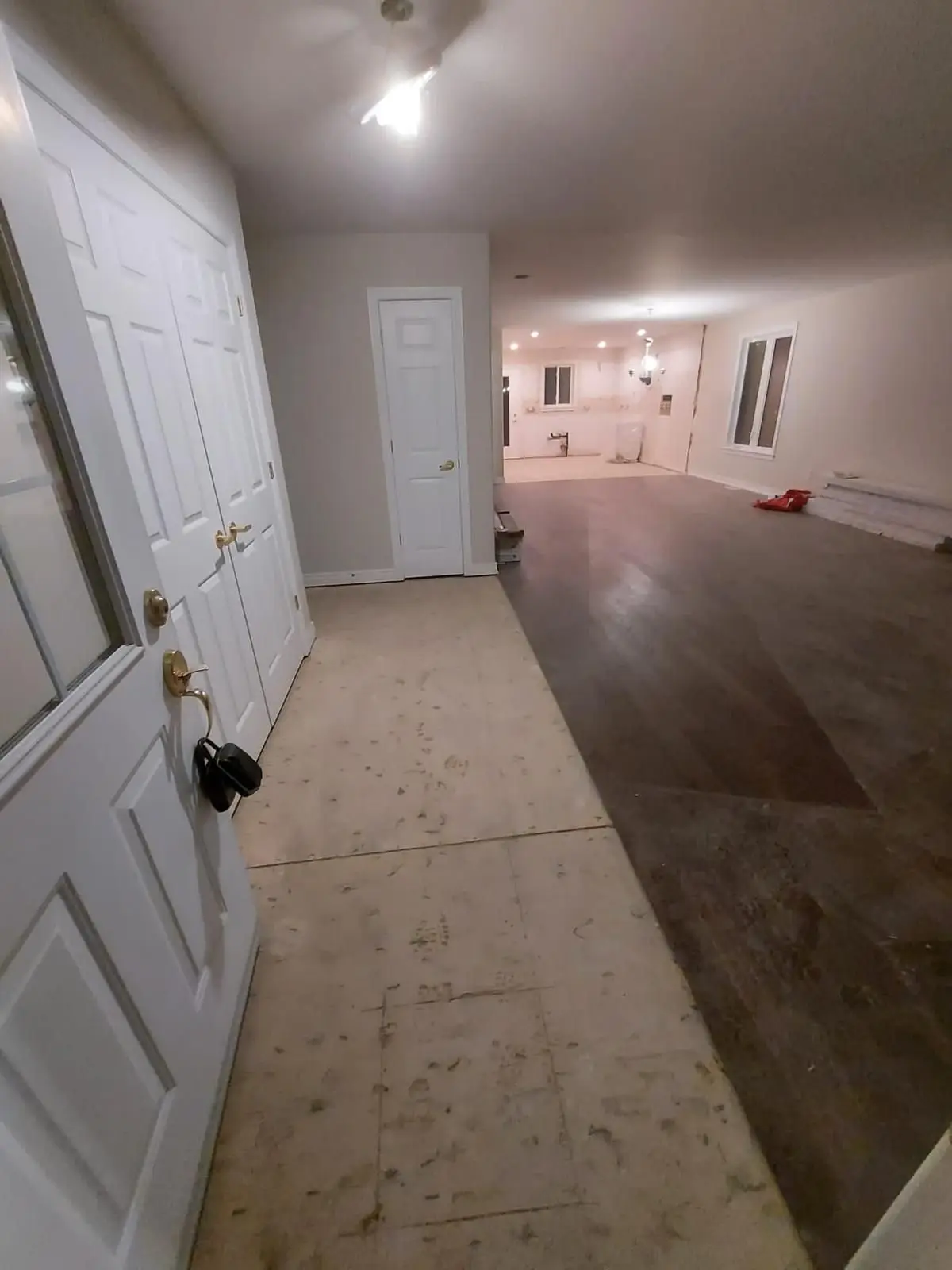

    Finishing — Kitchen corner view showing installed white cabinetry, quartz island countertop, marble backsplash, and stainless steel appliances.Finishing — Interior view of a closet with installed shelving and a paneled door.Finishing — Wide interior view from the front entryway looking into the unfinished living space and back rooms.
  4. Mid February 2023

    Both bathrooms

    Porcelain floor tile went into both washrooms first, then the vanities: a 24-inch in the smaller room and a 48-inch in the other, both with quartz tops, undermount sinks, black single-handle faucets and black pulls. Seven new shut-off valves went in behind the fixtures while the walls were still open. Same hardware finish as the kitchen, on purpose — a main floor done in one contract should not look like three different jobs.

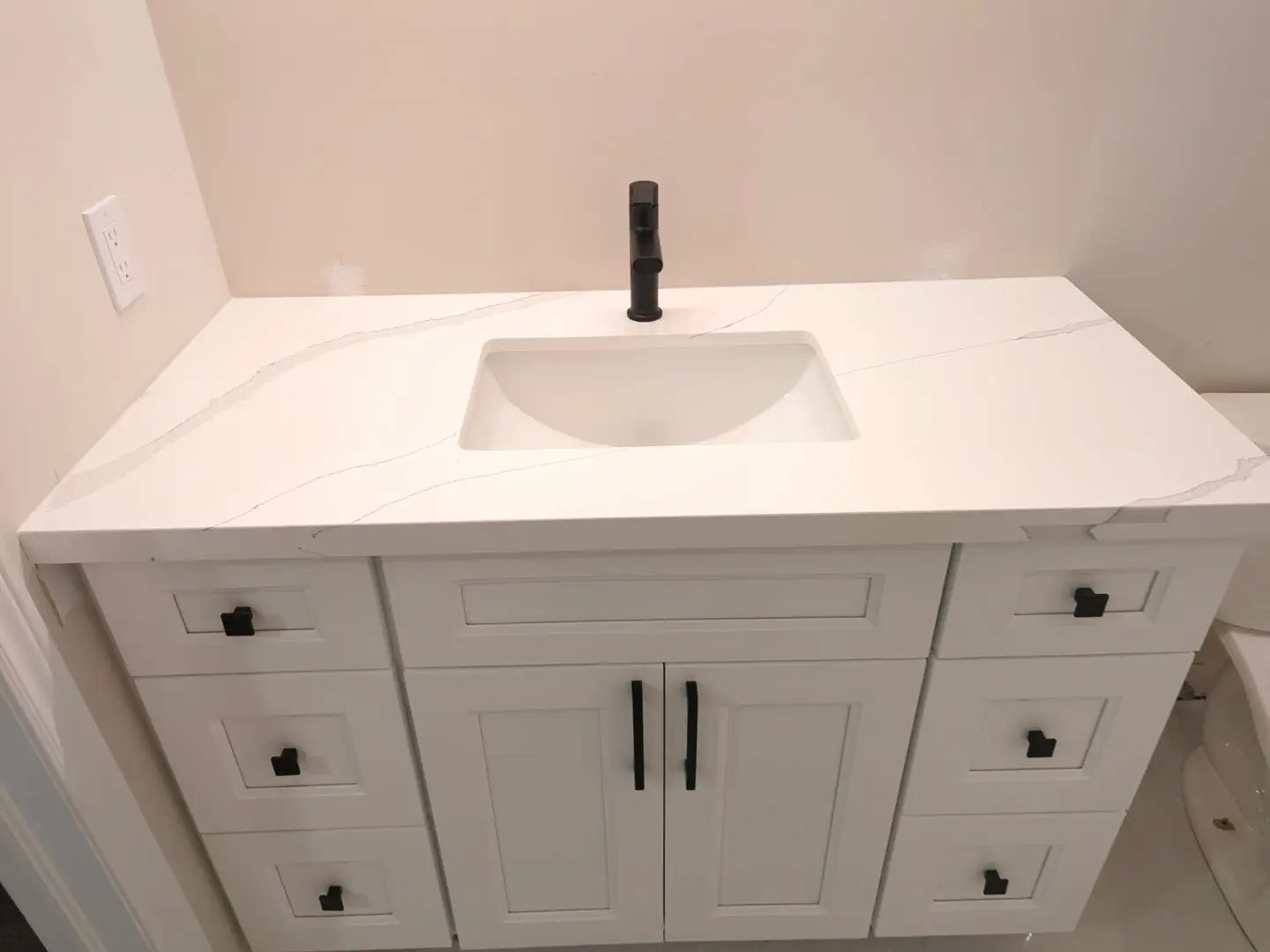

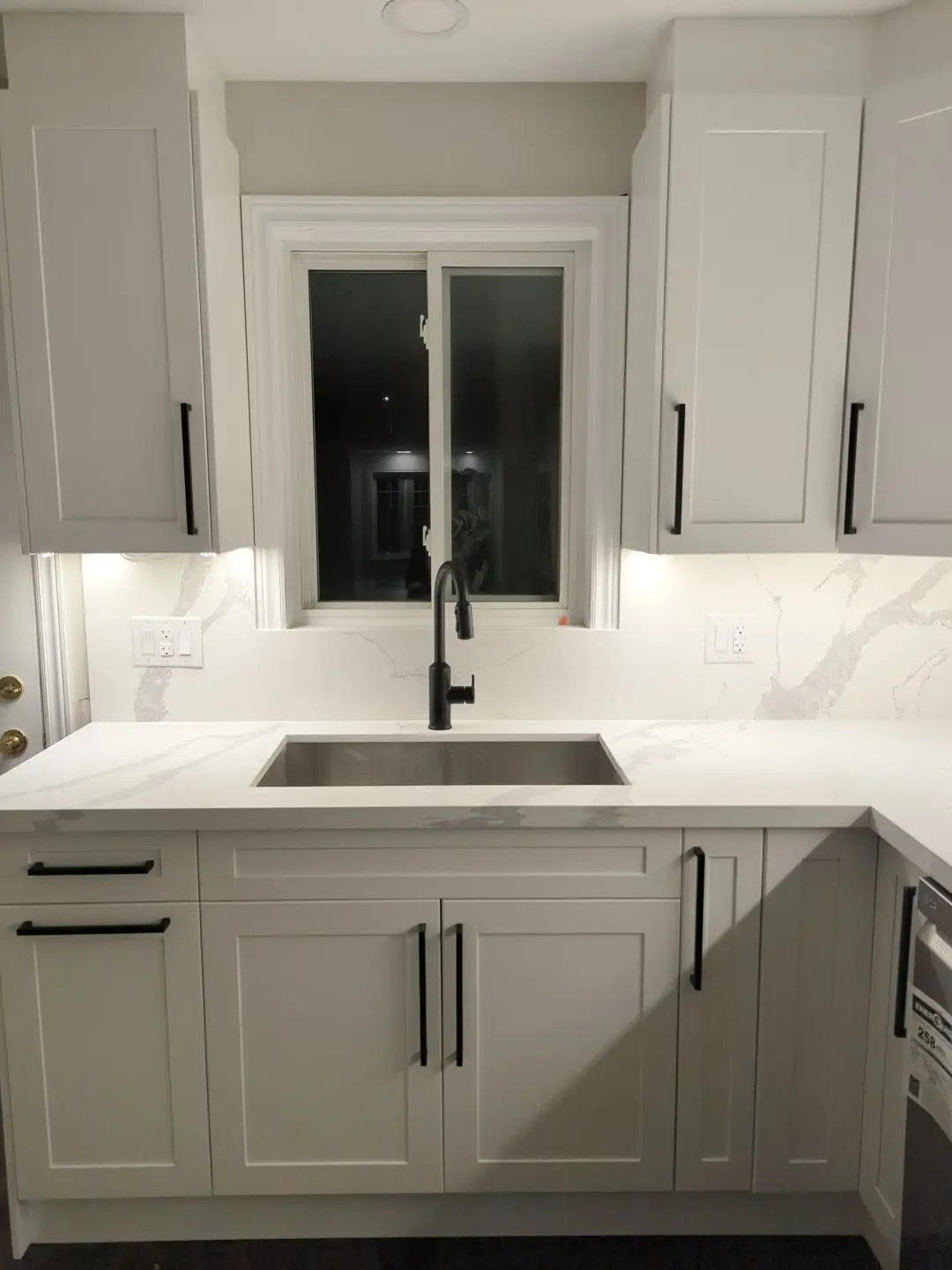

    Finishing — High angle shot of a newly installed white vanity with black hardware, white quartz countertop, and black faucet.Finished — Completed kitchen sink area with white shaker cabinets, quartz countertops, and black hardware.
  5. February 24, 2023

    The finished kitchen

    White shaker doors on 3/4-inch solid birch boxes, soft-close hinges and undermount soft-close glides throughout, black bar pulls. Calacatta-look quartz on the perimeter, on the 72-inch island, and carried up the wall as a full-height backsplash instead of tile. Tall pantry cabinets flank the fridge, the gas range sits in the run, and the undermount sink with a black faucet stays under the window. Eight pot lights plus under-cabinet valance LED on its own switch, and two receptacles built into the island so it works as a prep counter rather than a shelf. The hardwood runs out of the kitchen straight through the dining and living space — no threshold strip, no tile break at the doorway.

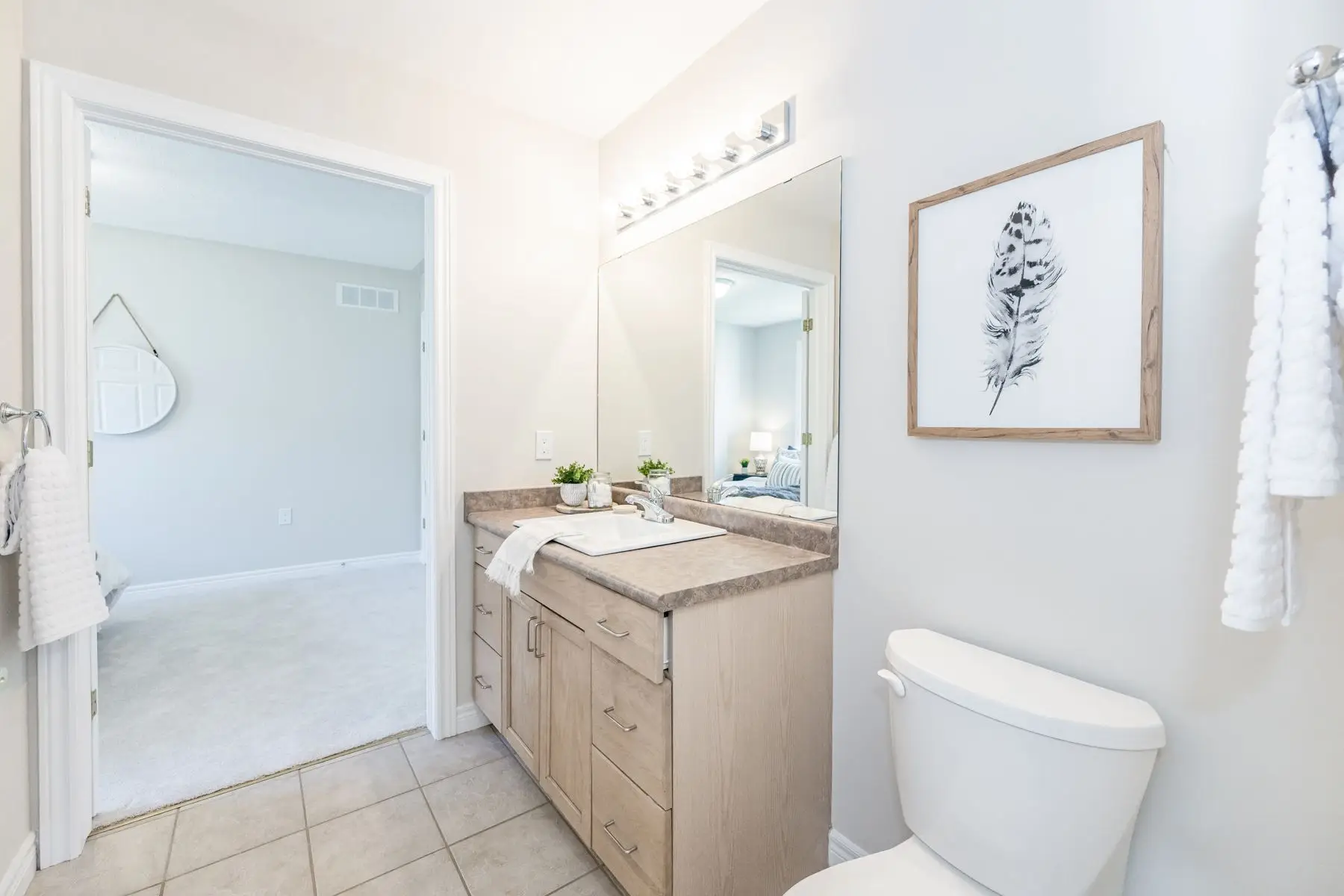

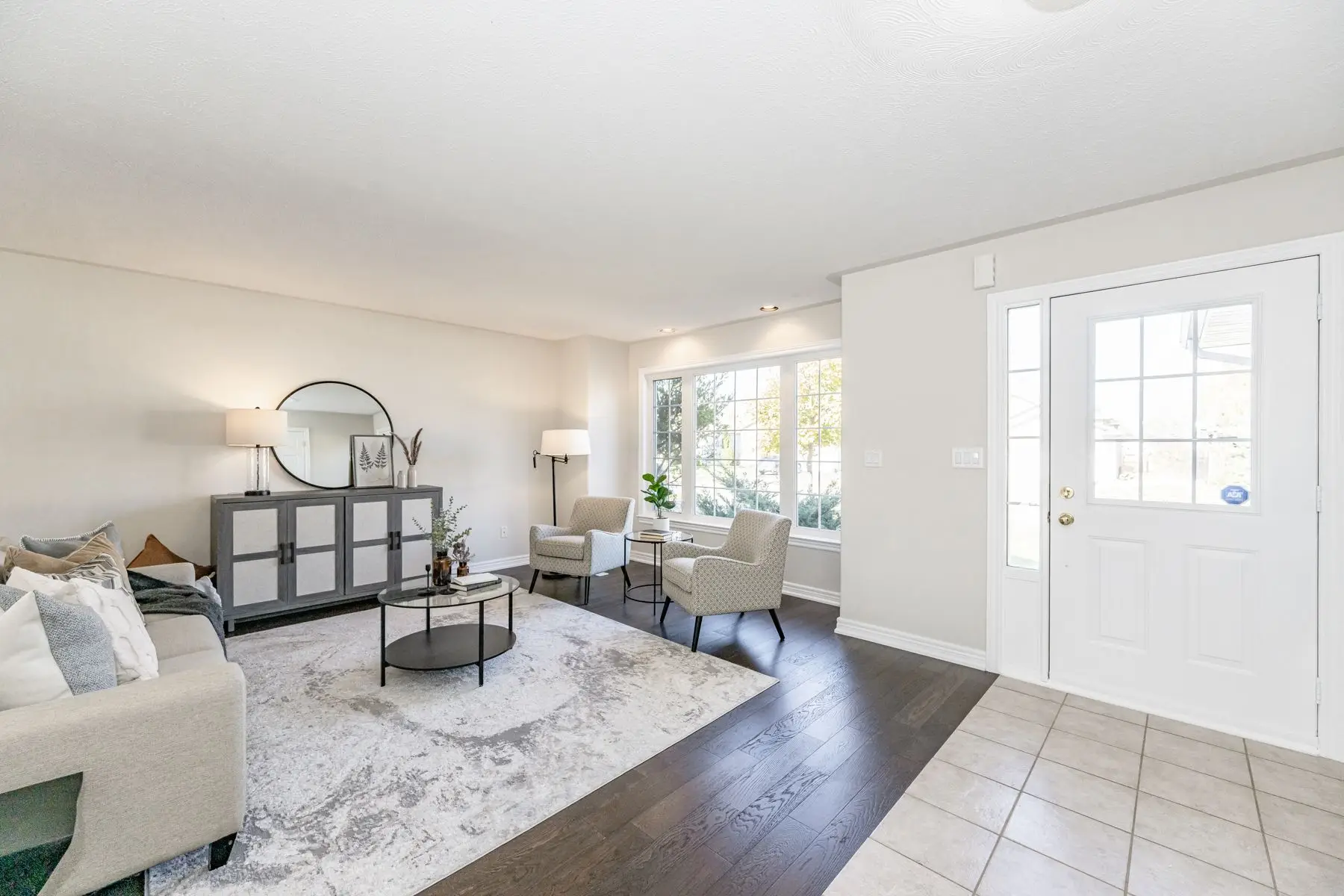

    Finished — Completed bathroom featuring wooden vanity, large mirror, and white toilet with doorway view into adjacent bedroom.Finished — Completed bright living room with dark hardwood floors, white entry door, and staged furniture.

The result

Contracted at two to three weeks from a February 6, 2023 start; the finished photos were shot February 24, 2023. A closed perimeter kitchen with laminate counters and a tile floor became a 25 LF island kitchen with quartz counters and a full quartz backsplash. Both bathrooms got new porcelain floors and quartz-topped vanities. Nine hundred square feet of popcorn ceiling came off and was plastered and painted, and 650 sq ft of hardwood now runs unbroken through the main living area. Base contract $34,481 + HST, with licensed electrical at $2,096 + HST and licensed plumbing at $1,399 + HST approved as separate quotes.

Questions about projects like this

How long does a whole main-floor renovation like this actually take?

This one was contracted at two to three weeks and landed in that window: February 6, 2023 start, finished photos February 24. That pace depends on an empty house. Demolition of the kitchen, both vanities, all the flooring and the baseboards happened in one pass, the ceilings were scraped and plastered while the floor was still subfloor, and hardwood went down before the cabinets arrived. If you are living in the house through it, plan on longer — the work has to be broken into zones and protected between visits.

What did a 25-linear-foot kitchen with a quartz island cost on this project?

The full main floor was $34,481 + HST in early 2023. That covered demolition and disposal, 25 LF of solid birch cabinets, the 72-inch island, quartz counters and quartz backsplash, 650 sq ft of hardwood, porcelain tile in two washrooms, a 24-inch and a 48-inch vanity with quartz tops, new baseboard, and removing, plastering and painting 900 sq ft of popcorn ceiling. Licensed electrical was $2,096 + HST and licensed plumbing $1,399 + HST on top of that. Those are 2023 numbers — cabinet and stone pricing has moved since, so treat it as a shape, not a quote.

Do you need a building permit to replace a kitchen or remove popcorn ceilings in Ontario?

Not for like-for-like cosmetic work. Replacing cabinets, counters, flooring and vanities, and removing ceiling texture, does not require a building permit when you are not touching structure, relocating plumbing stacks, or changing exterior openings. This project stayed inside that line and ran without one. The separate issue is asbestos: texture coatings in older homes can contain it, and they should be tested before anyone starts scraping. That is a health and safety requirement, not a permit.

Is it cheaper to do the kitchen, both bathrooms and the flooring at the same time?

Yes, and this project is the argument for it. One demolition crew took out the cabinets, both vanities, the tile, the carpet and the baseboards in the same visit. The hardwood was installed as one continuous 650 sq ft floor before the kitchen went in, so there is no threshold strip where the kitchen meets the living space and no seam to hide. Splitting the same scope into three separate jobs means paying three times for mobilization, dust protection and floor transitions, and living with mismatched hardware and floor heights between them.
