Bathroom Renovation in Ajax: Finishing What Another Contractor Left — completed by HMH Construction

Project story · Ajax

Bathroom Renovation in Ajax: Finishing What Another Contractor Left

Ajax, Ontario. We ground the existing shower pan back to a true slope, rebuilt the wet areas on cement board, and finished the room in large-format marble-look porcelain — 13 working days, start to handover.

Location
Ajax
Completed
2022
Duration
13 working days over three weeks (Nov 7 – Nov 21, 2022)
Project value
About $20,000 including HST — about $16,000 base contract plus a $1,250 change order

We picked this bathroom up part-built. Another trade's tools were still on the floor when we walked in, and the shower pan already in place was out of slope and out of level badly enough that it had to be ground down before anything could be tiled over it. Three weeks later the room was done.

What the project had to achieve

Read from the scope of work: The contracted scope opens with clearing another trade's tools off the site and grinding the existing shower pan down to correct major imperfections in slope and level, then fixing the shower drain and redoing the shower faucet rough-in. That is the signature of a bathroom that was started, stalled, and needed the wet areas brought back into tolerance before the finishes could go on. The project was built to achieve two things: a shower that drains properly and is waterproofed correctly under the tile, and a finished, usable main-floor bathroom with the tub, double vanity and glass enclosure the room was laid out for.

Project goals here are read from the signed scope of work. We don't publish our clients' names, addresses, or anything they told us in confidence.

Scope of work

How it was built

  1. Nov 7–12, 2022

    Substrate first — pan, framing and cement board

    Nothing goes on top of a bad base. The existing shower pan was ground down to correct the slope and level, the drain was fixed, and the pan was rebuilt with a quarter-inch fall toward the wall side. We framed the tub alcove, raised the subfloor an inch under the tub so the drain landed where that model needed it, and added back framing wherever the board needed a nailer. Then 64 sq ft of cement board went on the tub wall, tub side and shower floor, and the room floor got 90 sq ft of self-leveller. The hex mosaic pan was set before the walls so the drain elevation was locked in.

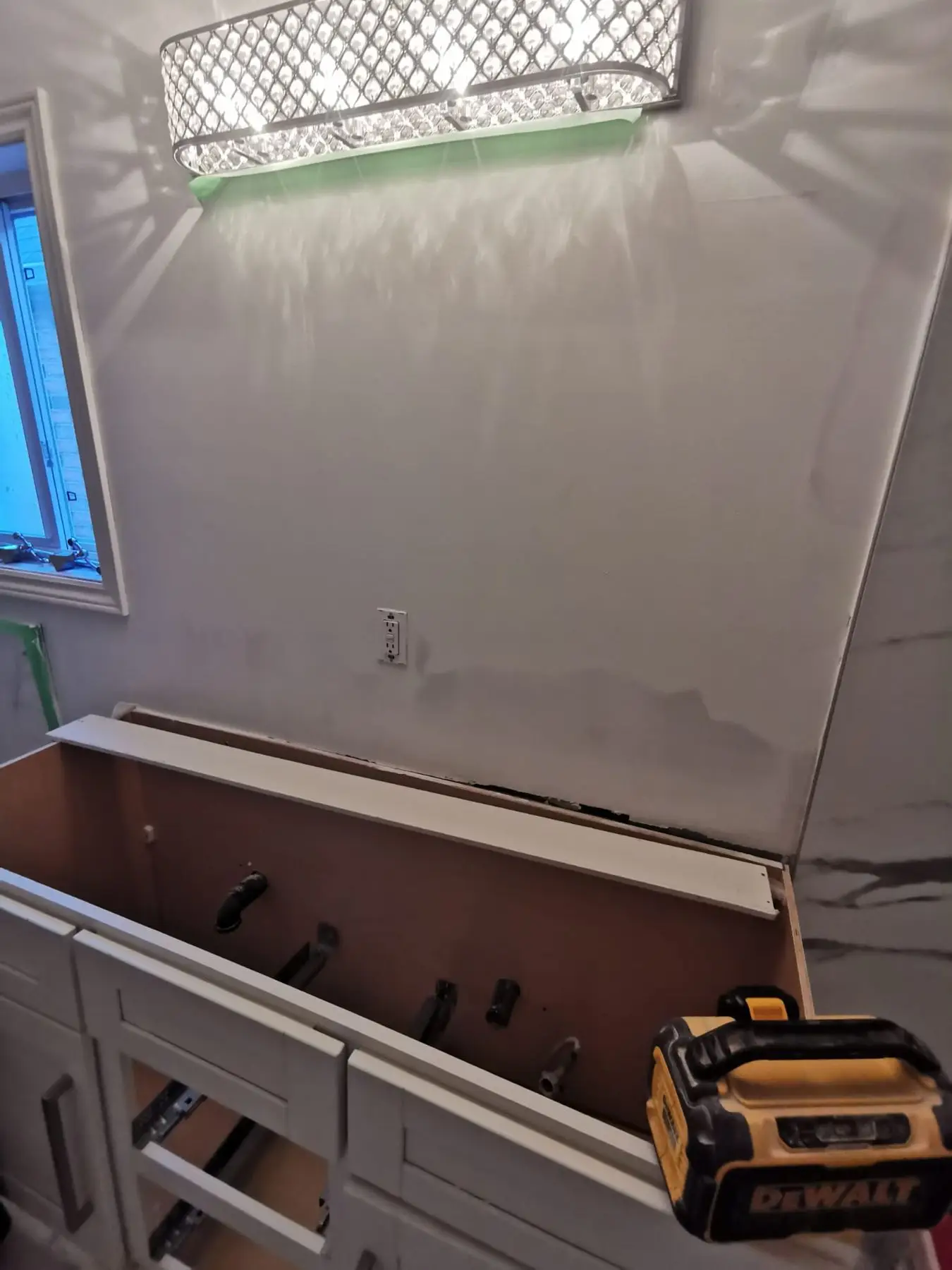

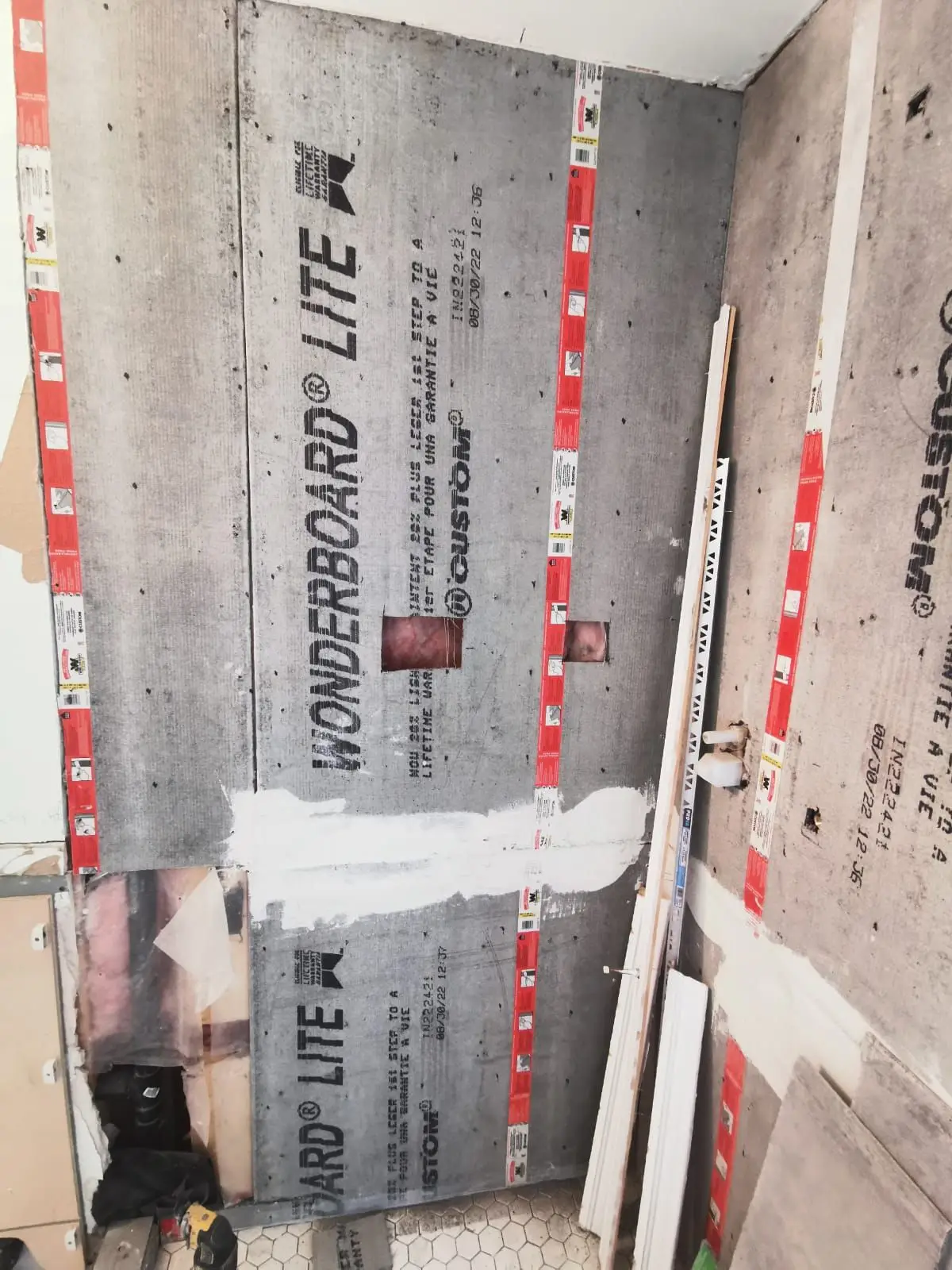

    Rough-in — Bathroom wall partially installed with WonderBoard Lite cement backer board and taped seams.Rough-in — Close-up of an open wall access box revealing interior plumbing and wiring.Insulation & drywall — Bathroom vanity base installed under drywall patching phase with a Dewalt radio on top.
  2. Nov 9–14, 2022

    Large-format tile

    The shower walls are 4'x8' marble-look porcelain slabs, run so the veining carries across the panels. Sheets that size are unforgiving — the wall has to be flat and the mortar coverage has to be full behind every inch, or you get hollow spots and lippage you can see from the door. The tub surround got the same slab in 32 sq ft, and 130 sq ft of 2'x4' porcelain went down on the floor. Grouting followed on the Saturday.

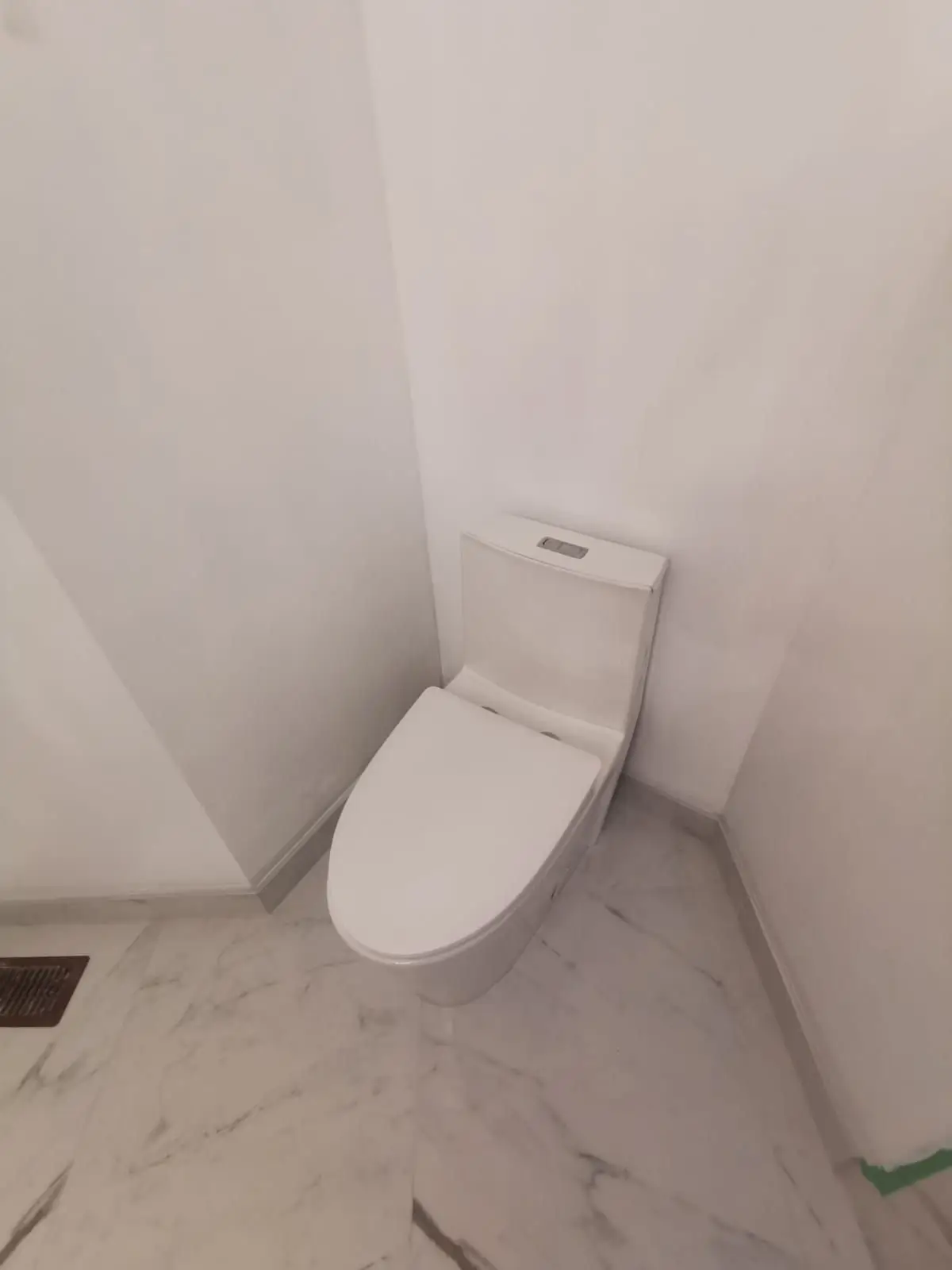

    Finishing — A newly installed white modern toilet in the corner of a bathroom with marble-look floor tiles.Finishing — Corner of a room with paint buckets, supplies, and tools stored on the floor.
  3. Nov 14–19, 2022

    Trim, paint and finish plumbing

    Casings and flatstock baseboard in, wood-filled and caulked. Walls and ceiling painted, trim in semi-gloss. Then the fixtures: dual-flush toilet, two shower faucets, vanity faucet, exhaust fan, and the shower column with its handheld. The recessed niche was tiled out in the same hex mosaic as the pan — added by change order once the wall was open and the position was set.

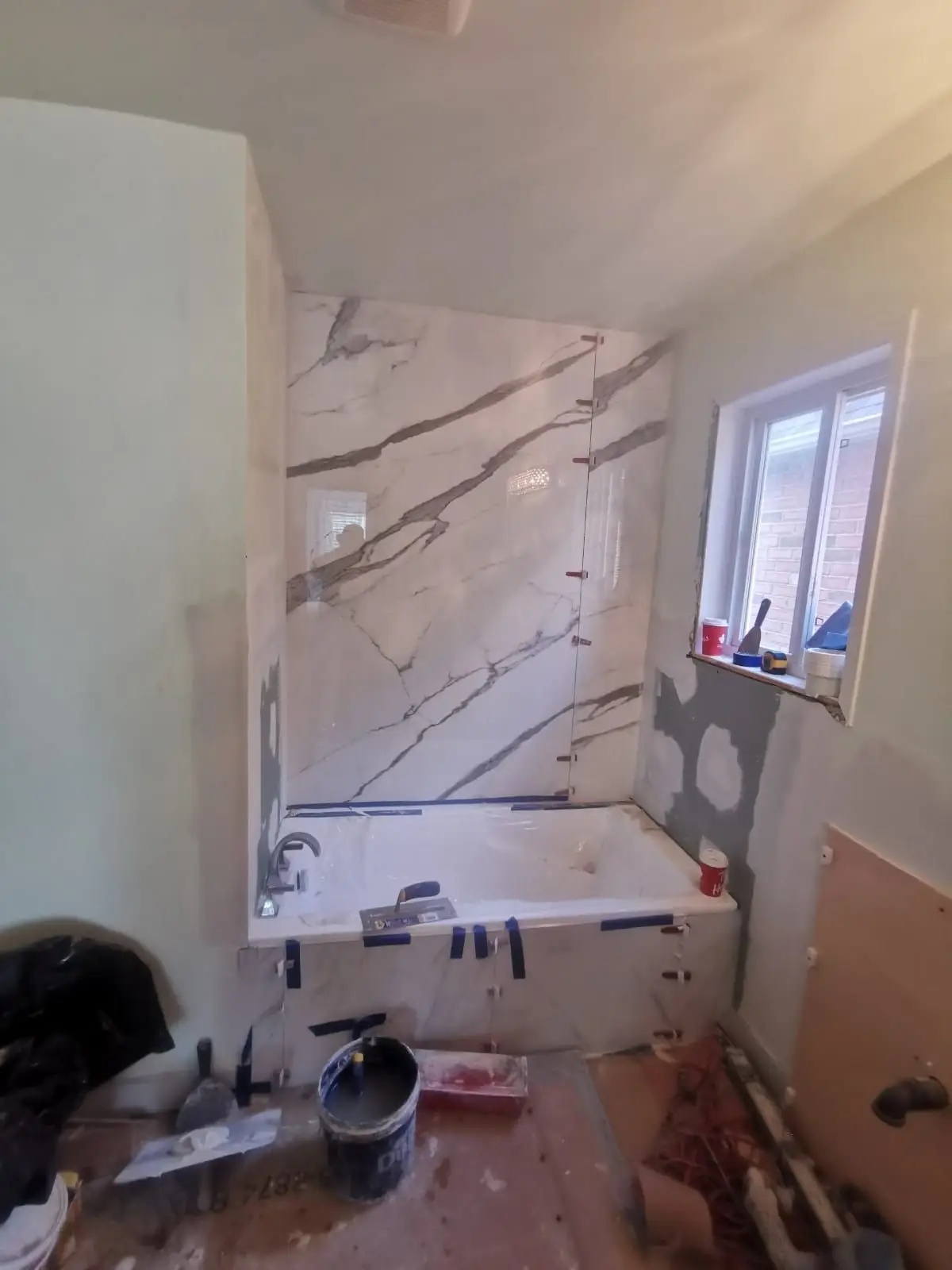

    Finishing — Bathroom renovation showing large format marble-look tile installation around bathtub and unpainted drywall.Finishing — Bathroom with completed marble-look tile shower, sliding glass door, white vanity, and construction debris left inside.Finished — Completed modern bathroom featuring a double vanity, large glass shower, and marble-look tiles.
  4. Nov 21, 2022

    Glass in, room handed over

    The 10 mm glass went in as a two-sided corner enclosure with a sliding door, so the shower reads as part of the room instead of a box in the corner. The double vanity was reinstalled and assembled, twin mirrors and the light bar hung, hardware set, and the last paint touch-ups closed out. Final milestone signed off on November 21.

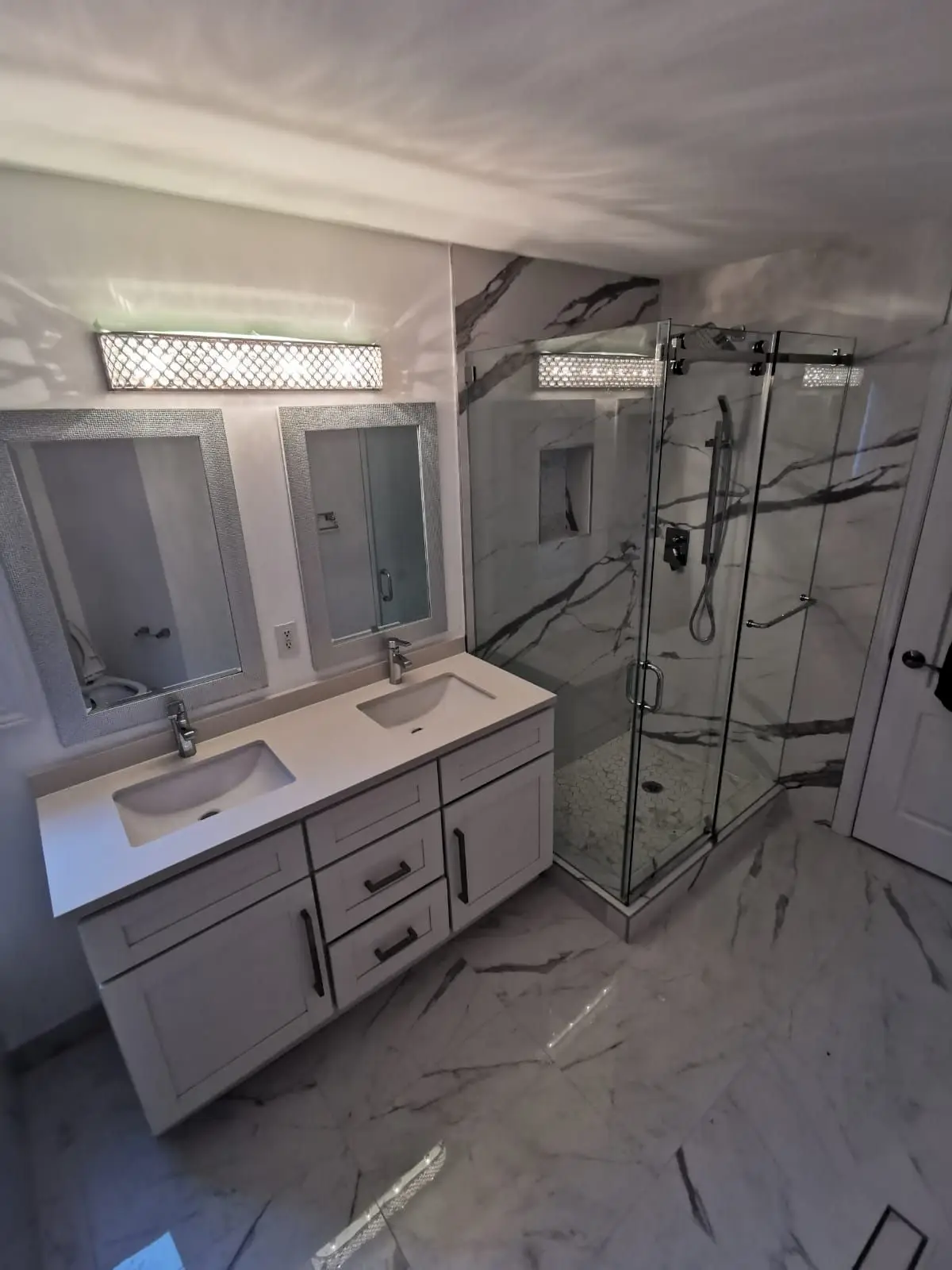

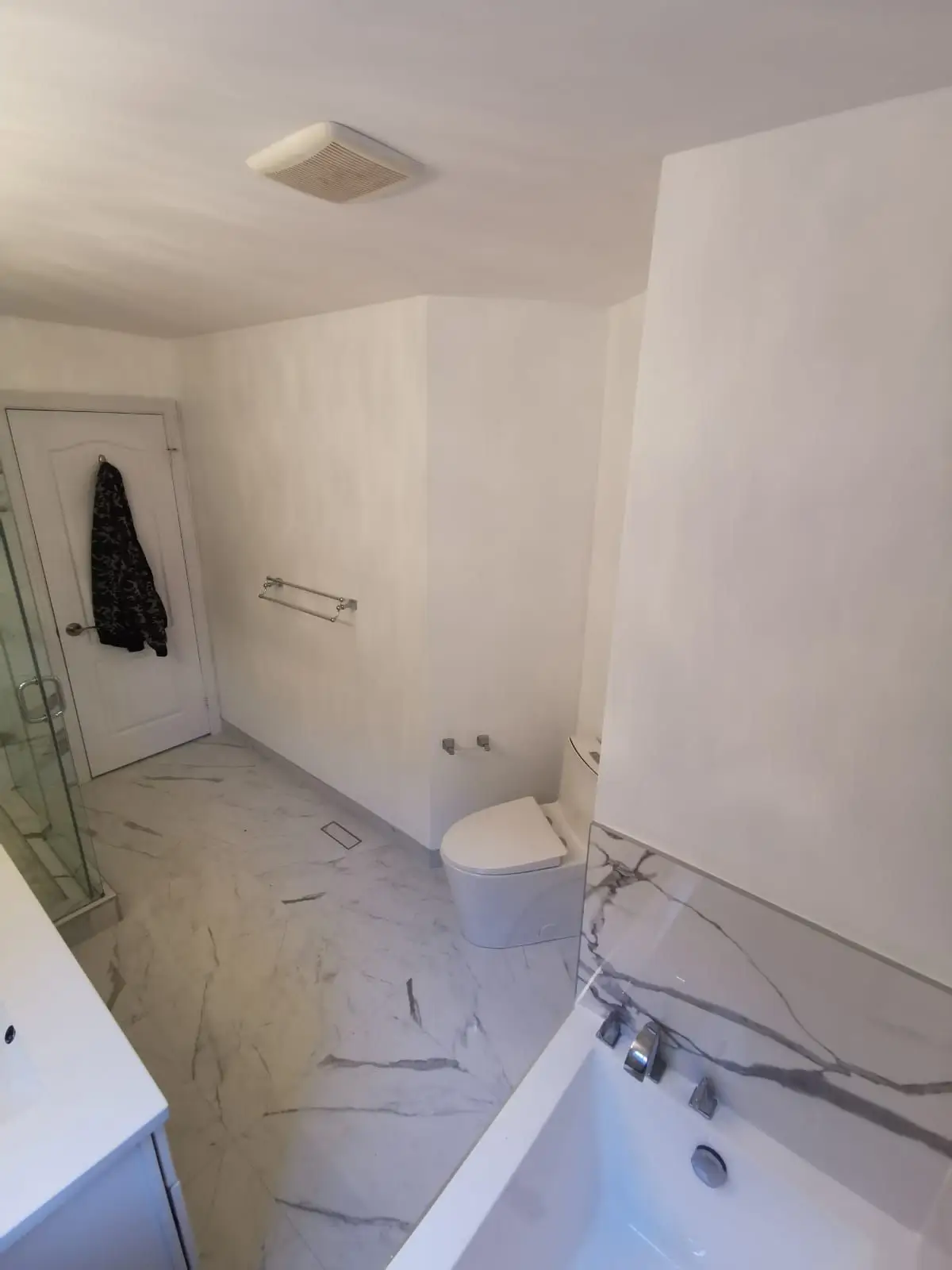

    Finished — High angle shot of a finished modern bathroom with double vanity, glass shower, and marble-look tiling.Finished — High-angle view of a finished bathroom featuring a marble tile floor, soaking tub, glass shower, and modern toilet.

The result

A finished main-floor bathroom with a shower that drains the way it should. The pan was corrected and re-sloped rather than tiled over, the wet walls sit on cement board, and the 4'x8' porcelain slabs run flat and continuous from the pan to the ceiling. Alcove tub with a matching slab surround, double vanity with twin mirrors, and a two-sided 10 mm glass corner enclosure. Delivered across three payment milestones — 35 percent complete on Nov 10, 70 percent on Nov 17, 100 percent on Nov 21, 2022. One change order of $1,250 plus HST covered the shower faucet redo, the cement board patch, the niche and baseboard tiling and the extra tub-side slab; the shower base re-slope, the mirror hang and the hardware install were done at no charge.

Questions about projects like this

How long does a full bathroom renovation take?

This one took 13 working days spread over three weeks — started November 7, 2022 and handed over November 21. That covered demolition, framing, rough-in plumbing, cement board, self-levelling, all the tile, trim, paint, finish plumbing and the glass enclosure. A single bathroom of this scope generally runs two to four weeks. What stretches it is waiting on glass, which is measured only after the tile is done and set, and any change orders that open a wall back up. On this project the change order added 1.75 days to the schedule.

Can a contractor take over a bathroom another contractor started?

Yes, and we do it regularly. The important part is not assuming the work already in place is right. Here the shower pan was already built, so before we tiled anything we ground it down to correct major slope and level defects and fixed the shower drain, then re-established a quarter-inch fall toward the drain. We also redid the shower faucet rough-in and patched the cement board around it. Expect a takeover to be priced with some correction work in it — anything we cover with tile, we own.

What slope does a tiled shower base need?

The standard is 1/4 inch of fall per foot from the perimeter to the drain. On this project the corrected base was sloped a quarter inch toward the wall side where the drain sits. Get this wrong and water stands on the pan, grout stays wet, and the mosaic joints discolour within a year. It is also why we set the hex mosaic pan before tiling the shower walls — it locks the finished drain elevation in before anything above it commits.

Can you use 4-by-8-foot large-format tile in a shower?

Yes, and it is the reason this shower has almost no grout lines. Two things make it work. The substrate has to be genuinely flat before you start — we ran cement board over the wet walls and self-leveller over the floor. And you need full mortar coverage behind the whole sheet, back-buttered, because a hollow spot behind a panel that size will crack it later or sound drummy under a knuckle. Panels also need two people and a suction rig to place. Budget more labour than you would for standard 12x24.
